Meta Description: Plan your electronics project with confidence. This guide breaks down realistic PCBA lead times from PCB fabrication to final assembly, including key factors that impact delivery and how Kingsheng's optimized process ensures on-time delivery for prototypes and production.

On-time delivery rate
Introduction: Why Accurate Lead Time Planning is Critical for Your Project
In the fast-paced world of electronics development, an accurate project timeline is as crucial as the design itself. Unrealistic expectations for Printed Circuit Board Assembly (PCBA) lead times can derail product launches, strain budgets, and compromise market opportunities.
The journey from a Gerber file to a fully assembled, tested board involves multiple interdependent stages—each with its own variables. Understanding these stages and their typical durations is the first step toward reliable planning.
This article provides a transparent, stage-by-stage breakdown of realistic PCBA timelines and explains how partnering with a manufacturer like Kingsheng, with its disciplined Cost And Delivery Control, can help you navigate and optimize this critical path.
The PCBA Timeline: A Stage-by-Stage Breakdown

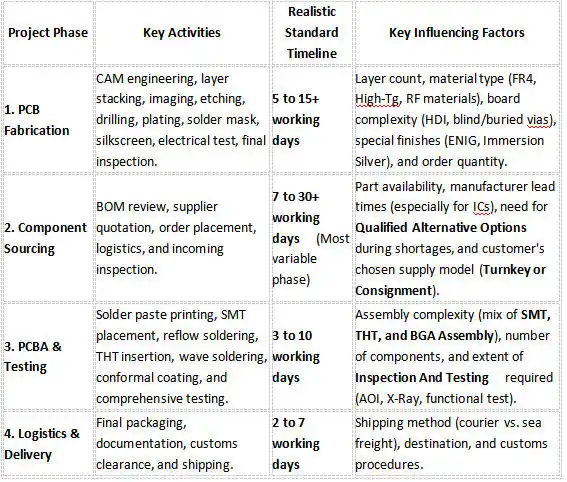

A typical turnkey PCBA project involves four core phases. The timeline below outlines a realistic range for standard service, with expedited options often available.

Factors affecting PCBA delivery
Total Realistic Turnkey Timeline (Standard): ~15 to 60+ working days.
Deep Dive: What Drives Variability in Each Phase?
PCB Fabrication:
Complexity is King: A simple 2-layer board can be produced in 3-5 days. A 12-layer board with impedance control and heavy copper weights will take significantly longer. Panelized PCB/PCBA strategies can optimize assembly time but may add to fab panelization engineering time.
Material Matters: Exotic substrates (like Rogers for high-speed designs) may not be in stock, adding procurement time.
Component Sourcing (The Biggest Wildcard):
This phase can single-handedly determine your project's fate. A single long-lead-time component (like a specialized microcontroller) can stall the entire project.
Kingsheng's Mitigation Strategy: Our Electronic Components Sourcing expertise and Qualified Alternative Options service are critical here. We proactively identify potential shortages and provide pre-validated alternates to keep your project moving.
PCBA & Testing:
First-Time-Right Design: A clean design with a thorough DFM/DFA check (part of our Strong Engineer Services) avoids time-consuming engineering change orders (ECOs) mid-process.
Quality vs. Speed: Comprehensive testing (X-Ray for BGA Assembly, functional testing) adds time but prevents costly field failures. This is non-negotiable for Automotive and Medical Systems projects.
How Kingsheng Optimizes Lead Times Without Compromising Quality
Our process is built to provide predictability, a value born from the discipline of automotive manufacturing.
Front-Loaded Engineering (Our "Strong Engineer Services"): We invest time upfront. A detailed design review and DFM/DFA analysis identify and resolve potential fabrication and assembly issues before they become delays on the production floor.
Proactive Supply Chain Management: We don't just place orders. We leverage our supplier relationships and market intelligence to forecast lead times accurately and source Qualified Alternative Options at the first sign of a shortage, a crucial part of our Optimization Solution.
Structured Production Flow: From Quick-turn prototypes to Medium And Large Production Runs, our factory floor operates on a controlled schedule. Advanced machinery like High-Speed Chip Shooter Machines and 12-Zone Reflow Ovens ensure efficient, repeatable assembly.
Clear Communication & Transparency: Through our Online Quote and project management system, you receive regular updates, so there are no surprises. We believe realistic expectations, set early, are key to a successful partnership.
Expedited Services: When You Need It Faster
For all phases, expedited options exist at an additional cost. Kingsheng offers:
Conclusion: Partner for Predictable Timelines
PCBA lead time is a composite of many factors, but it doesn't have to be a mystery. By understanding the standard phases, acknowledging the variables (especially in component sourcing), and partnering with a manufacturer that has a systematic approach to Cost And Delivery Control, you can plan with greater accuracy and confidence.
Ready to get a realistic timeline for your next PCBA project? Contact Kingsheng today for a detailed Online Quote. Leverage our expertise in Turnkey And Consignment Assembly to bring your product to market reliably and on schedule.
With 17 years of expertise in PCBA design, manufacturing, and service, KingshengPCBA is ready to help turn your ideas into reality. Feel free to contact us anytime to discuss your requirements and get a professional quotation.
Please send Email to kspcba@c-alley.com or call us through +86 13828766801 Or submit your inquiry by online form. Please fill out below form and attach your manufacturing files( PCB Gerber files and BOM List) if need quotation. We will contact you shortly.
+86 13828766801
kspcba@c-alley.com
https://www.kingshengpcba.com/
2/F, Building 6, Tangtou 3rd Industrial Zone, Tangtou Community, Shiyan Town, Baoan District, Shenzhen, China, 518108
